Construction Updates
Join our construction mailing list
Construction management for 10 World Trade is a partnership between Suffolk Construction and H.J. Russell.

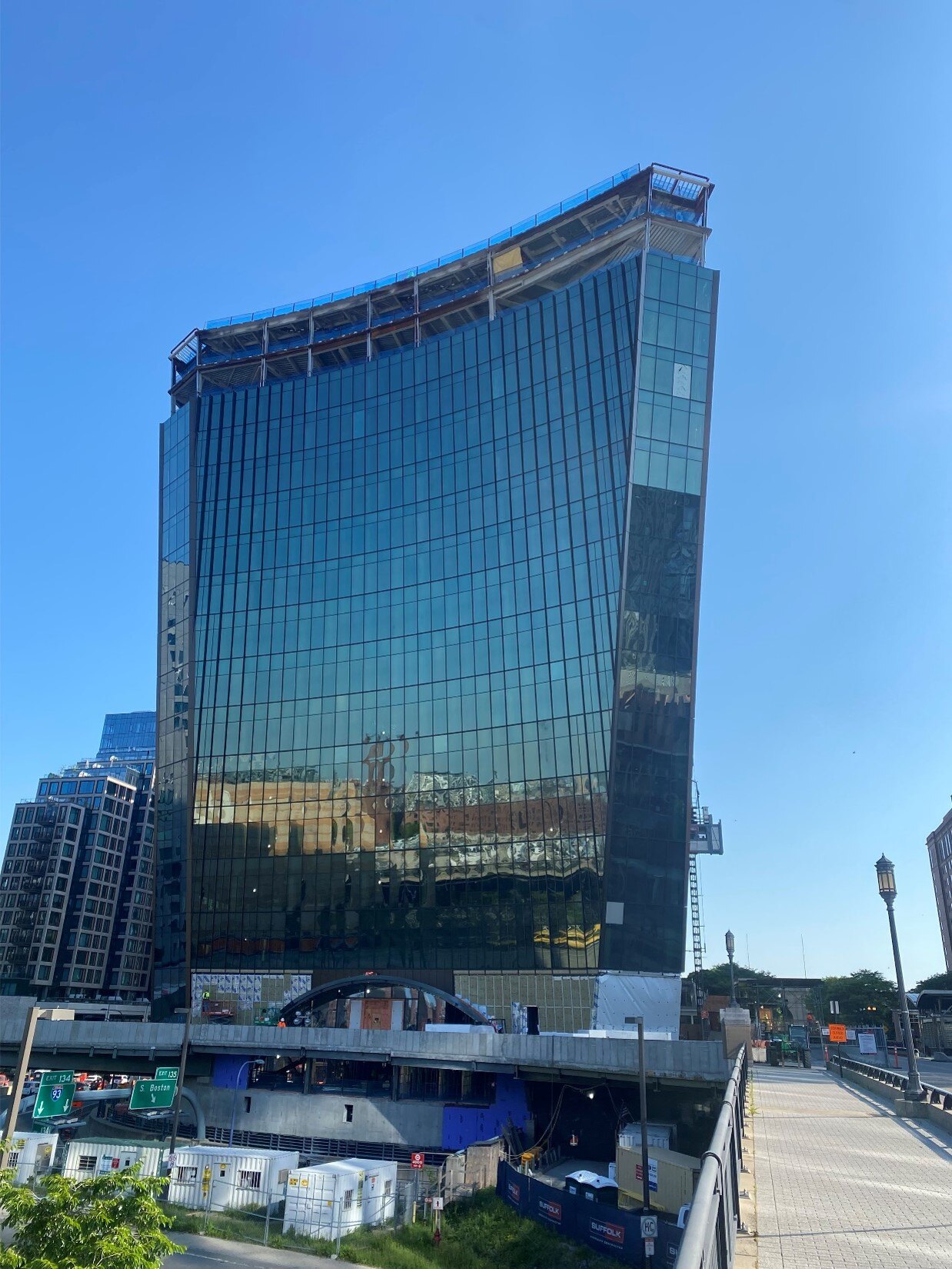

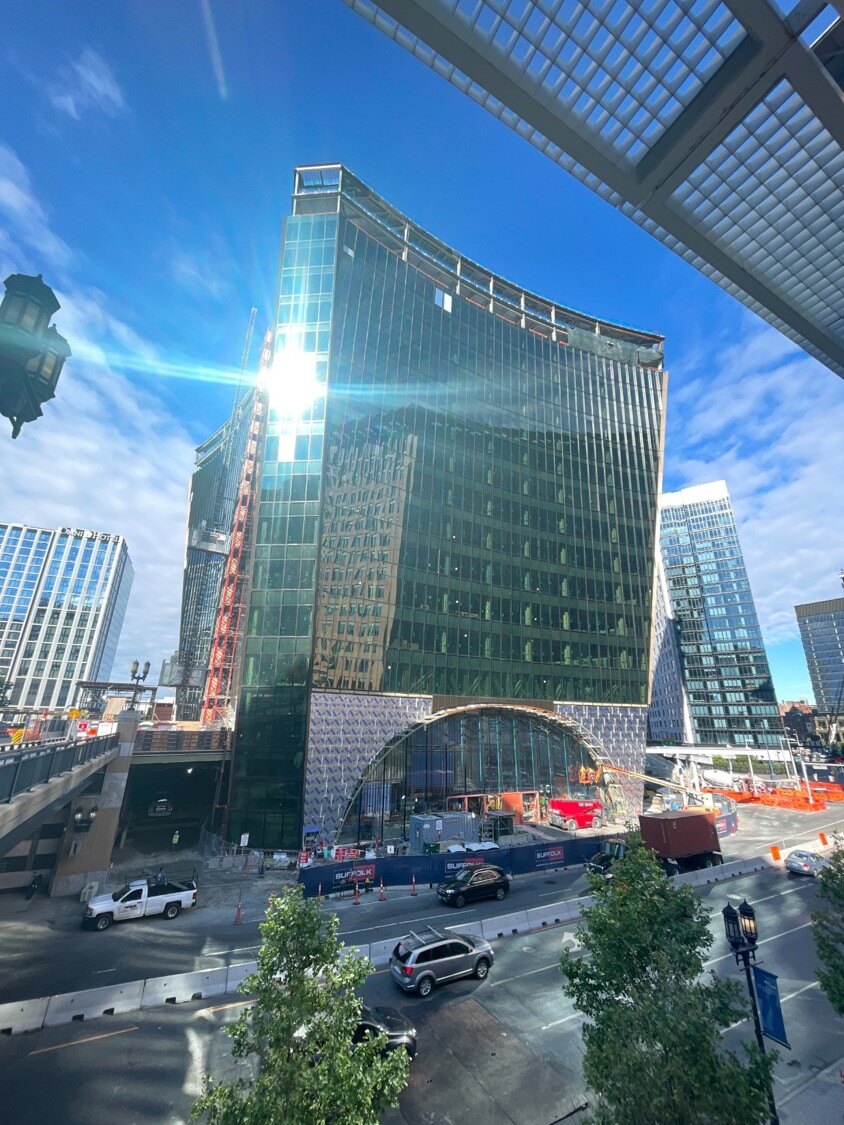

09/25 - 10/06
- Complete Steel Framing & Decking through Level 15
- Complete Concrete Placement through Levels 10-11

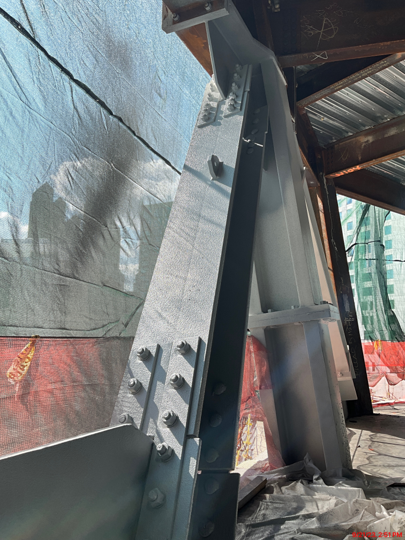

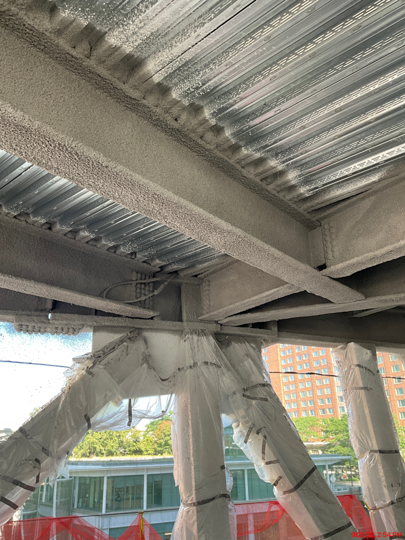

- Continue Intumescent Paint & Spray Fireproofing of lower levels (01-04)
- Continue prep for landscape @ Congress Street & WTC Ave
- Continue prep for curtainwall through Level 12
- Eversource Permanent Power installation @ Congress Street: awaiting confirmation of timing.
Night & Weekend Work:
- Saturday Day Shift Work to be requested on case-by-case basis.
- Fire Protection piping in Congress St @ Triangle Parcel: complete
- Pedestrian Bridge Steel welding: Thursday 9/21 (11pm-5am). Ramp F closed to..
Construction Archive

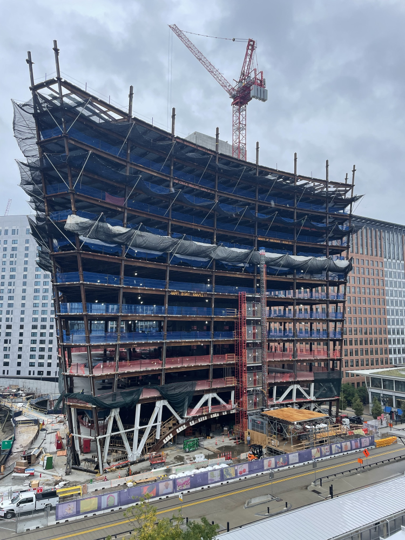

Complete Steel Framing & Decking through Level 14 Complete Concrete Placement through Levels 10-11 Pour concrete @ Slab on Grade & Mezzanine Continue...
Complete Steel Framing & Decking through Level 13 Complete Concrete Placement through Level 09 Pour concrete @ Basement Continue spray Fireproofing of lower...
Complete Steel Framing & Decking through Level 13 Complete Concrete Placement through Level 08 Pour concrete @ Basement Continue spray Fireproofing of lower...
Complete Steel Framing & Decking through Level 12 Complete Concrete Placement through Level 08 Pour concrete @ Basement Continue spray Fireproofing of lower...
Complete Steel Framing & Decking through Level 10 Complete Concrete Placement through Level 07 Start concrete @ Auditorium seating Continue excavation for...
Complete Steel Framing & Decking through Level 09 Complete Concrete Placement through Level 07 Excavation for Basement along Congress Street Start Spray...
Complete Steel Framing & Decking through Level 08 Complete Concrete Placement through Levels 04 Excavation for Basement along Congress Street Start Spray...
Complete Steel Framing & Decking through Level 07 Complete Concrete Placement through Levels 02 Form & pour Level 03 deck Excavation for Basement along...
Complete Steel Framing & Decking through Level 06 Complete Concrete Placement through Levels 02 Complete Steel Framing through Level 07 Form & pour Level 03...
Complete Steel Framing & Decking through Level 05 Complete Concrete Placement through Level 02 Continue Steel Framing through Level 06 Form & pour Level 03...
Continue Level 04 framing Complete Steel Framing & Decking through Level 04 Complete Concrete Placement through Level 02 Continue Steel Framing through Level...

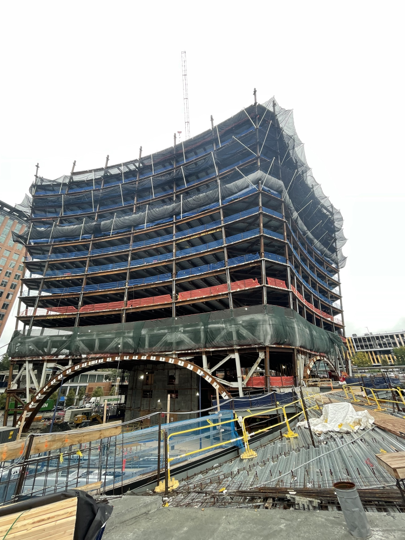

Continue Levels 03-04 framing Continue steel welding & decking at Triangle Parcel (park) Curtainwall Embeds – Level 02 Pour Level 02 deck See night/weekend...
Continue Level 04 framing Continue steel detailing at Triangle Parcel (park) Curtainwall Embeds – Level 02 Pour Level 02 deck See night/weekend work for...
Continue Levels 03-04 framing Continue steel welding & decking at Triangle Parcel (park) Curtainwall Embeds – Level 02 Pour Level 02 deck See night/weekend...
Continue Levels 03-04 framing Continue steel welding & decking at Triangle Parcel (park) Curtainwall Embeds – Level 02 Pour Level 02 deck See night/weekend...
Continue Levels 03-04 framing Continue steel welding & decking at Triangle Parcel (park) See night/weekend work for Pedestrian Bridge information ...
Continue Levels 03-04 framing Continue install of overhead protection work at highway ramp Continue steel assembly / detailing on Triangle Parcel ...
Grade beams complete – continue utilities connections on site. Continue Level 02 south framing (see below re: Ramp F traffic impacts) Complete detailing of...
Grade beams complete – continue utilities connections on site. Continue Level 02 south framing (see below re: Ramp F traffic impacts) Start assembly of West...
Grade beams complete – continue utilities connections on site. Continue Level 02 south framing (see below re: Ramp F traffic impacts) Start assembly of West...
Continue below-grade work along west and north of A-2 site. Continue steel assembly / detailing at Levels 2 - 3. Continued below-grade work throughout...
Patriots’ Day / Marathon Monday (04/17): No work on site. Continue below-grade work along west and north of A-2 site. Continue steel assembly / detailing at...
Continue below-grade work along west and north of A-2 site. Continue steel assembly / detailing at Level 03. Pour tower core slab Levels 04-05 Continue...
Continue below-grade work along west and north of A-2 site. Continue assembly of East arch (alongside WTC Ave). Continue steel assembly / detailing at Levels...
Continue below-grade work along west and north of A-2 site. Continue assembly of East arch (alongside WTC Ave). Continue steel assembly / detailing at Levels...
Demobilize core climber. Continue below-grade work along west and north of A-2 site. Prepare for assembly of East arch (alongside WTC Ave). Continue...
Tower Core Wall Reinforcement & Installation (Level 17-Roof) Steel arch assembly for South Arch (opposite Congress Street) Steel frame erection of Level 01...
Continue installation of pile caps, waterproofing, and grade beams Concrete Tower Core (Levels 13-16) Steel arches have arrived! Assembly starting along...

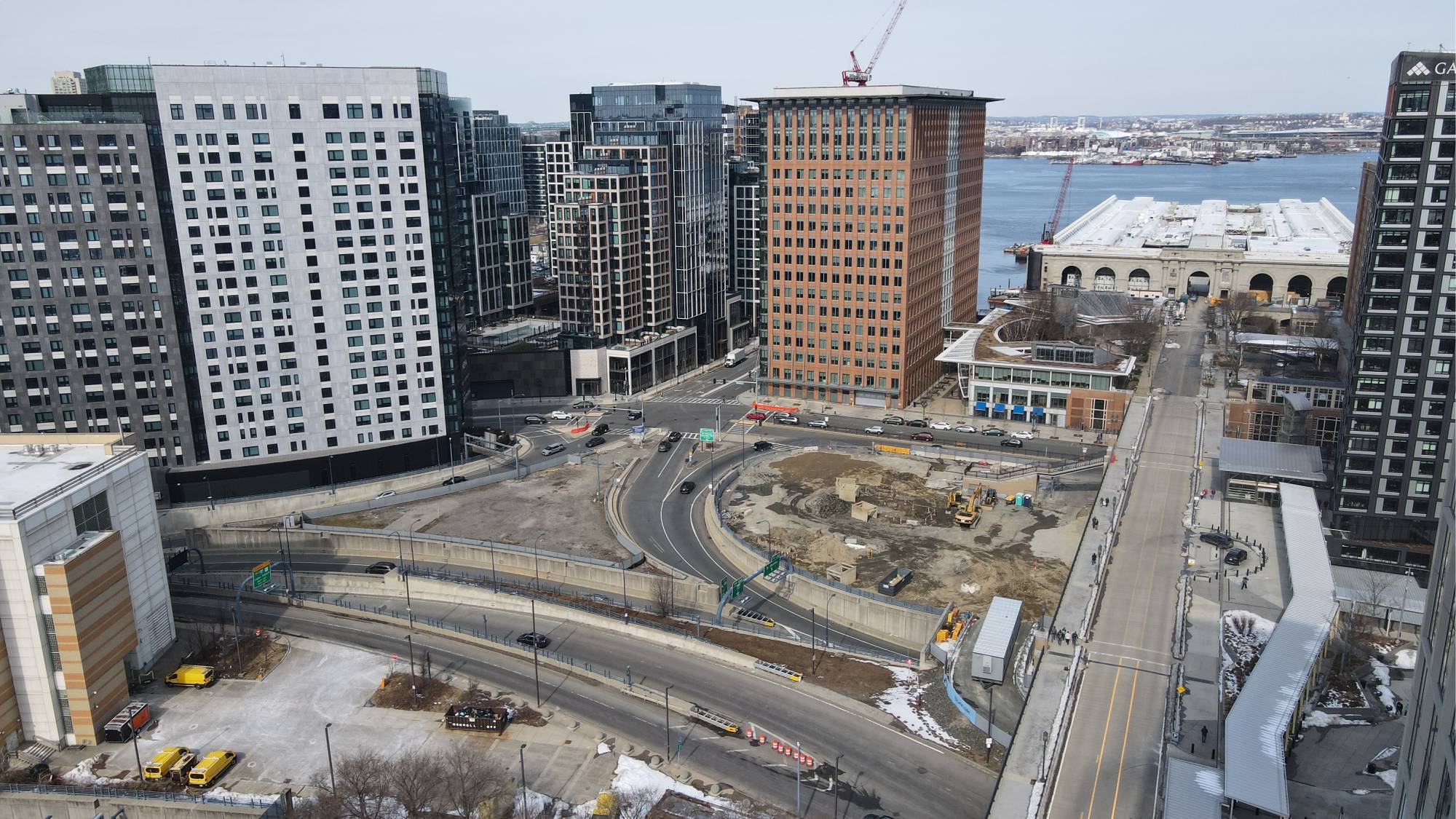

02/21-03/03 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure
02/13-02/24 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure
02/06-02/17 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure
01/30-02/10 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure ○ Parcel A-2: Continue...
01/23-02/03 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure ○ Parcel A-2: Continue...
01/16-01/27 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure ○ Parcel A-2: Continue...
01/09-01/20 Triangle Parcel: Continued utilities work Continued installation of grade beams in preparation for steel structure ○ Parcel A-2: Continue...
During the first week of December, foundation work was completed, including the installation of LBE's, Drilled-in Mini Piles, and Pressure Injected Footings...
In October, the first phase of the custom art scrim project was installed at the Congress Street level. In addition to showcasing 21 custom art pieces from a...
